2026 Road Reconstruction

Phase 4 Road Reconstruction | June 1 - July 14, 2026 Updated.

Vendors

Communications

Village Specific Communications

  • Please note that while certain homes and roads are impacted on June 22nd and 23rd, the main road, Ponderosa Drive from Flat Iron Loop to Superstition Mountain Drive, will be available to be used until it is paved on Wednesday at 6 a.m. on June 24th. Ponderosa Drive will be closed, and you will have no access by car from 6 a.m. on the 24th until 6 a.m. on the 25th.

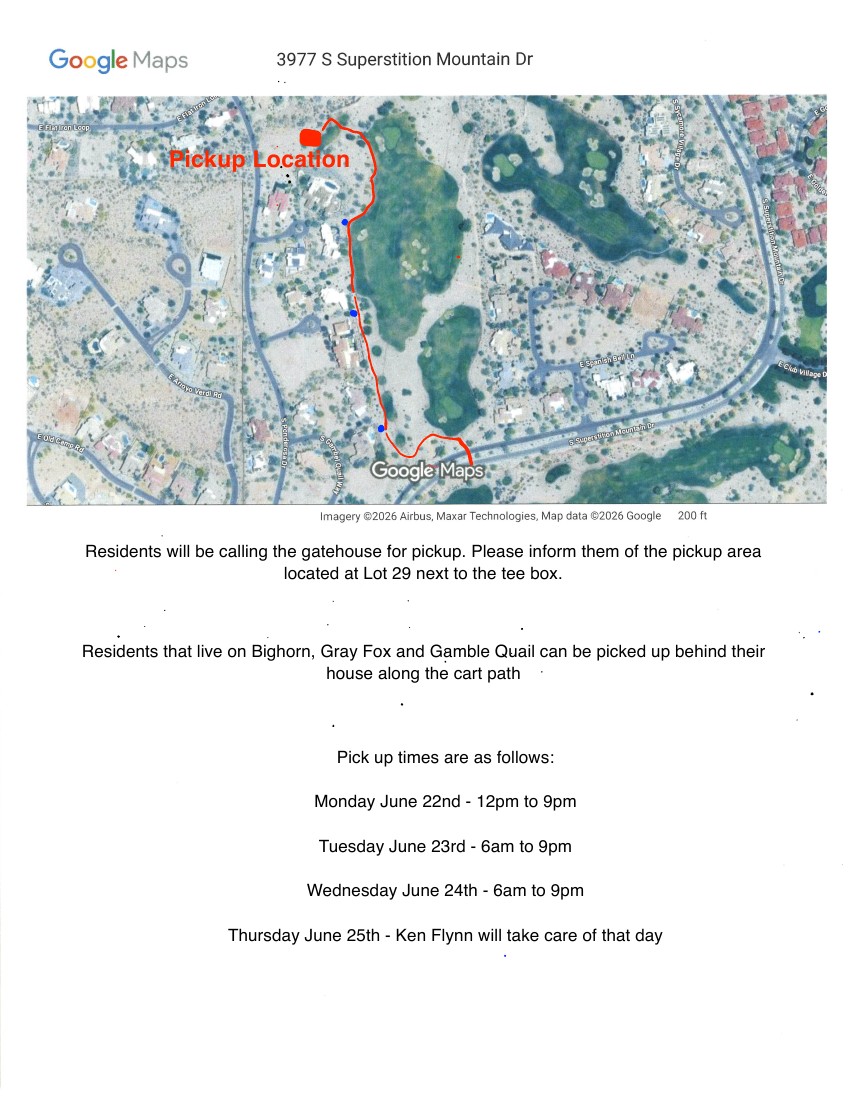

  • Golf Cart Taxi: If you need a ride to or from your parked car at the Carriage House parking lot, we will have a Golf Cart staffed and available to transport you from the evening of the 23rd until 9 pm and all day from 6 am until 9 pm on the 24th and the morning of the 25th after 6 am. Please call the Gatehouse at 480-983-9270.

Scope of Project

The SMOA is working with M.R. Tanner and Frank Civil Consulting on the fourth phase of road reconstruction in Superstition Mountain. These are the same consultants and contractors used in previous years. This project phase will cover all of Ponderosa Village, including Ponderosa Drive and all of Flat Iron Loop, as well as Greythorn, Bighorn, and Gamble Quail Way Courts.

Separately, ongoing asphalt maintenance will occur in Canyon View Estates, where the crack filling and sealcoating will meaningfully extend the life of that asphalt.

Ponderosa Village | June 1 - July 14, 2026

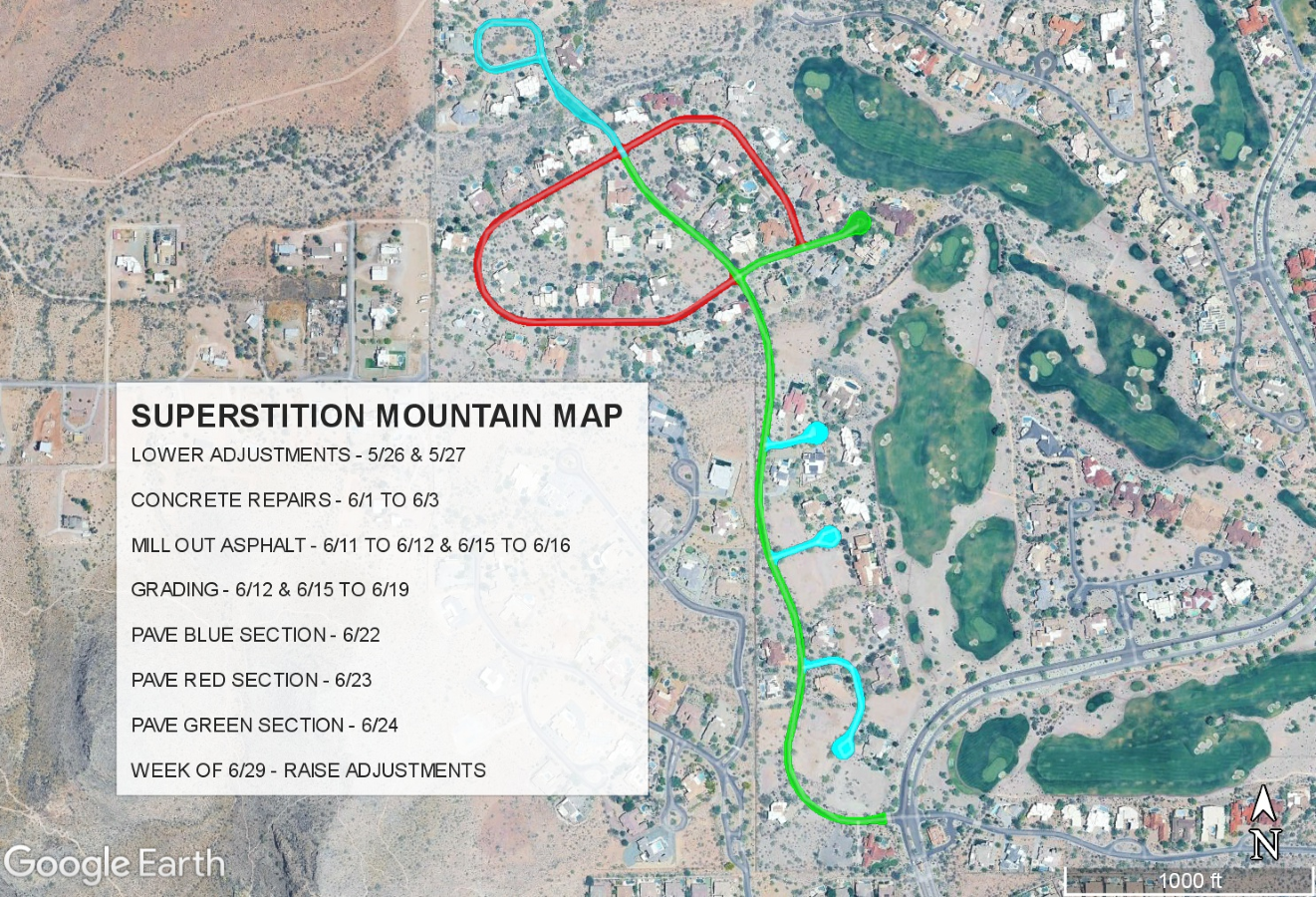

SUPERSTITION_MOUNTAIN_-_PAVING_MAP_202600001

FAQ's - Road Reconstruction

If I am not in Gold Canyon / won't be in the property on the paving days, is there anything I need to do for this project?
No. If you are not in the community and will not require vehicular access to your home, there is nothing additional you need to do.

We ask that you inform any vendors who may be servicing your home in this timeframe (pool vendors, house cleaners, etc.), so they can schedule around this disruption.

I will be home on these dates. Can I still access my home by other means?
No on the paving days. Detailed communications will be sent out in advance of the project to notify you of the disruptions, alternatives parking locations, and more.

Canyon View Estates | June 1 - June 29, 2026

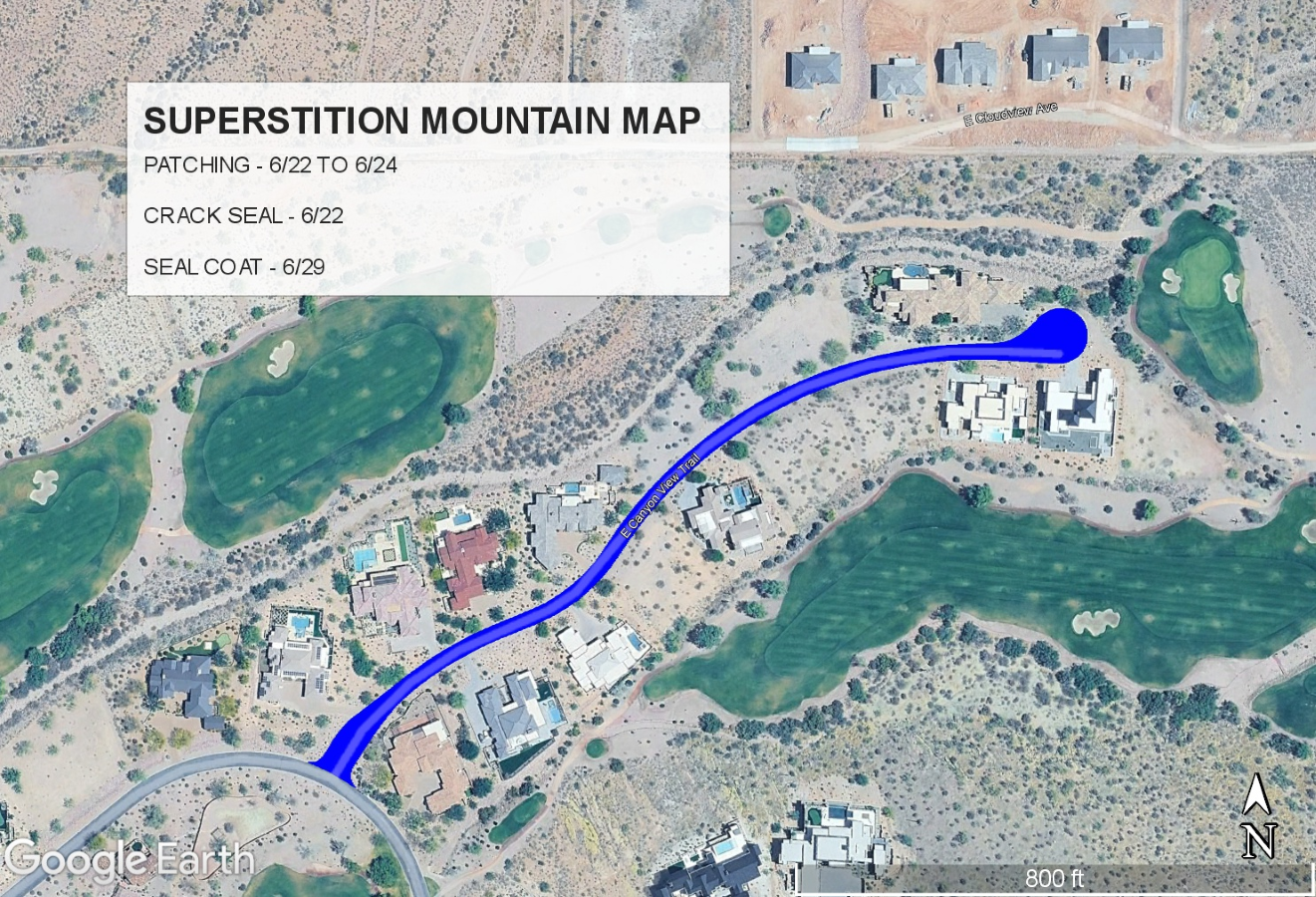

SUPERSTITION_MOUNTAIN_-_SEAL_COAT_MAP_2026

FAQ's - Seal Coat

If I am not in Gold Canyon / won't be in the property on the day of the Seal Coat, is there anything I need to do for this project?
No. If you are not in the community and will not require vehicular access to your home, there is nothing additional you need to do.

We ask that you inform any vendors who may be servicing your home in this timeframe (pool vendors, house cleaners, etc.), so they can schedule around this disruption.

I will be home on these dates. Can I still access my home by other means?
Yes, you can park your vehicle outside of the work zone. Which location is best will depend on your specific property location. You will then be able to walk to and from your vehicle as desired on the day of the sealing.

Other roads are being replaced; why is this road being crack-filled and seal-coated instead?
The Roads Committee makes this determination based on the current road conditions, long-term budgetary planning, and recommendations from Frank Civil Consulting.

As all roads will eventually be replaced, road maintenance is scheduled only where necessary and will extend the useful life of the road by at least 4 years.
